Water Improvement Project Overview

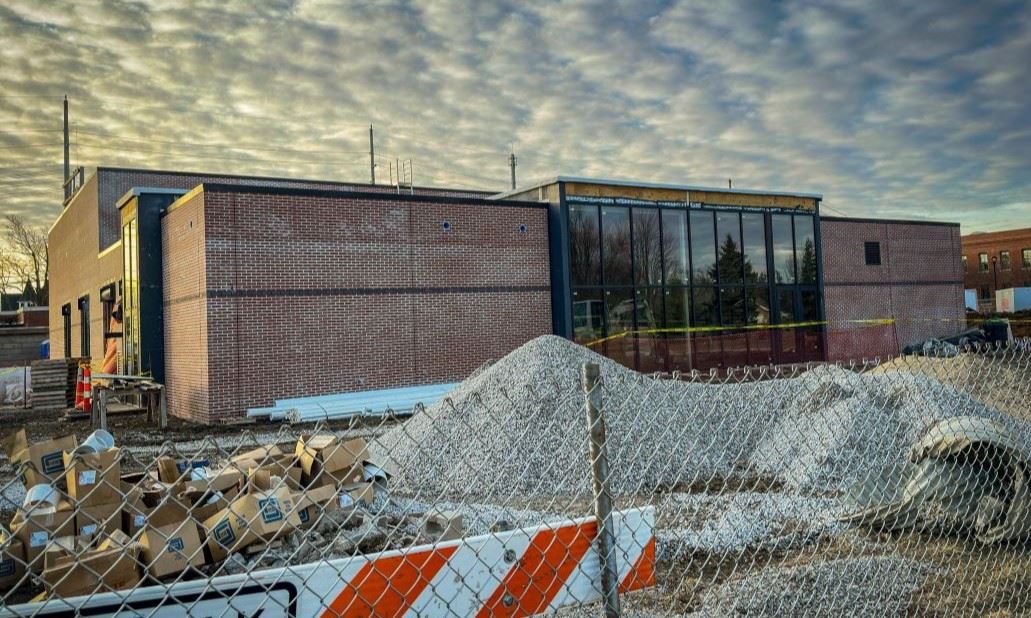

- 1 construction underway at the Grinnell water treatment plant
- 2 water tower with tank around base, corner of water treatment facility
- 3 construction of brick and block walls on the southeast corner of the water treatment plant
- 4 A crane stands beside a tall concrete water tower pillar under construction near a rural highway
- 5 Large boom pump pours concrete into wooden forms for the foundation of the water treatment plant
- 6 Excavation work underway at the new water treatment plant site
- 7 Drill rig at work on Jordan Well 10 near the water tower and water treatment plant
- 8 big holes in the street behind road closed signs and barriers in front of a water tower
- 9 Diagram showing water service line responsibility
- 10 Blue pipes stacked along the side of a street under construction with equipment in the distance
- 11 A drilling rig and water tower at a construction site under a clear blue sky with an American flag
- 12 A rendering of the future water treatment plant: a one-story brick building with tall windows
Water Improvements Project Outline:
The construction of a new water plant and other upgrades will improve drinking water quality, strengthen water supply resiliency, build capacity for growth, and the new nanofiltration technology used to soften water will offer a far superior alternative to Zeolite softening.
| Project | Overview | Status |
|---|---|---|
| Emergency water connection | The emergency connection was built as a backup to the current water plant. It is a safety measure that is not expected to be used, but is available in case of an emergency. This connection is complete and ready to be used if needed during the design and construction of the new treatment plant. | Complete |
| Water main replacement | This is part of an ongoing effort to improve the water supply system. This work has resulted in fewer water main breaks and better system reliability. Seven projects have replaced about three miles of water main in the last five years. More projects are planned. | Ongoing |
| New Jordan Well No. 10 | The Jordan Well No. 10 project will create a new drinking water supply well for the new water treatment plant. It will be located at 703 Broad Street, next to the new plant. Drilling started in summer 2024 and is expected to be complete in spring of 2026. The Jordan aquifer is a reliable water source, and is permitted by the Iowa DNR to remain reliable. | Mostly complete, with testing underway. |
| New raw water transmission line | The new raw water transmission main project targets a section that is prone to breaks, carrying water from Well 8 and Well 9 to the treatment plant. Making this system more durable will decrease breaks, supporting continued well operation at the new treatment plant. Construction began in summer 2024 and lasted around a year. | Complete |
| Construction of a new water tower | The City is expanding its finished water storage. The current 300,000 gallon water tower is in good condition, but this new tower will provide more water storage and allow for the retirement of the 300,000 gallon tower when needed. A new one million gallon water tower, located near East Street, south of Ogan Avenue, will be more resilient, support growth, and improve reliability. | Construction has begun and is estimated to be online in summer of 2026. |
| New drinking water treatment plant | The new water treatment plant, located at 703 Broad Street, will use nanofiltration technology to filter contents such as radium and hardness. A new clearwell will store finished water on site. The new plant will have the capacity to produce 2.6 million gallons of water per day. The current treatment plant building and storage reservoir will be demolished. | Construction has begun. Plant is expected to be operational January of 2027 and complete in summer 2027. |
- Why are water improvements taking so long?
-
Projects of this size usually require two years of planning, design, and permitting, and around two years of construction. The new drinking water treatment plant is on track to be online by December 2026.
- Is the water currently safe?
-
Yes, the water is safe. The city regularly monitors and tests the water quality as required by the Iowa Department of Natural Resources and the Environmental Protection Agency. Recent testing showed the water contained a higher level of radium than previous readings; however there is no immediate cause for concern.
- Will I still need to use my water softener with the new water treatment plant?
-
The use of water softeners is a personal preference. The new drinking water treatment plant will reduce water hardness down from 22 grains to 7 grains, a 68% reduction. The city needs to keep a safe level of water hardness in the water so it does not become corrosive. If customers continue to use water softeners, they will need to adjust their softener to the new water quality to see the cost savings in using less softener salt and minimize the harmful environmental impacts of water softener use.
- Will my water bill increase?
-
Yes. The city is looking at multiple funding options in order to keep rate increases as reasonable as possible. The water improvement projects will be funded through the following sources:
- Low interest and/or forgivable State Revolving Fund (SRF) loans
- Federal money through community project funding programs
- Water rate increases
Once the city has a more accurate total project cost, we will communicate any expected rate increases.
- Is the Jordan Aquifer a reliable source of water?
-
Yes. the Jordan Aquifer is a reliable source of water for many communities in the state of Iowa, including Grinnell. The Jordan Aquifer is one-half mile under ground. Water in the aquifer arrived there thousands of years ago, and as a result, does not contain any pollutants introduced by humans from the surface. Like any natural resource, its supply isn't infinite: water is pulled from the aquifer and there is a natural recharge as well. The state has spent several years studying the long-term viability of the aquifer and has implemented water conservation practices to ensure it remains reliable.
During the project planning phase, the city and their consultant team modeled aquifer drawdowns for Grinnell and determined the long-term pumping levels will remain well above the conservation limits regulated by the state.
